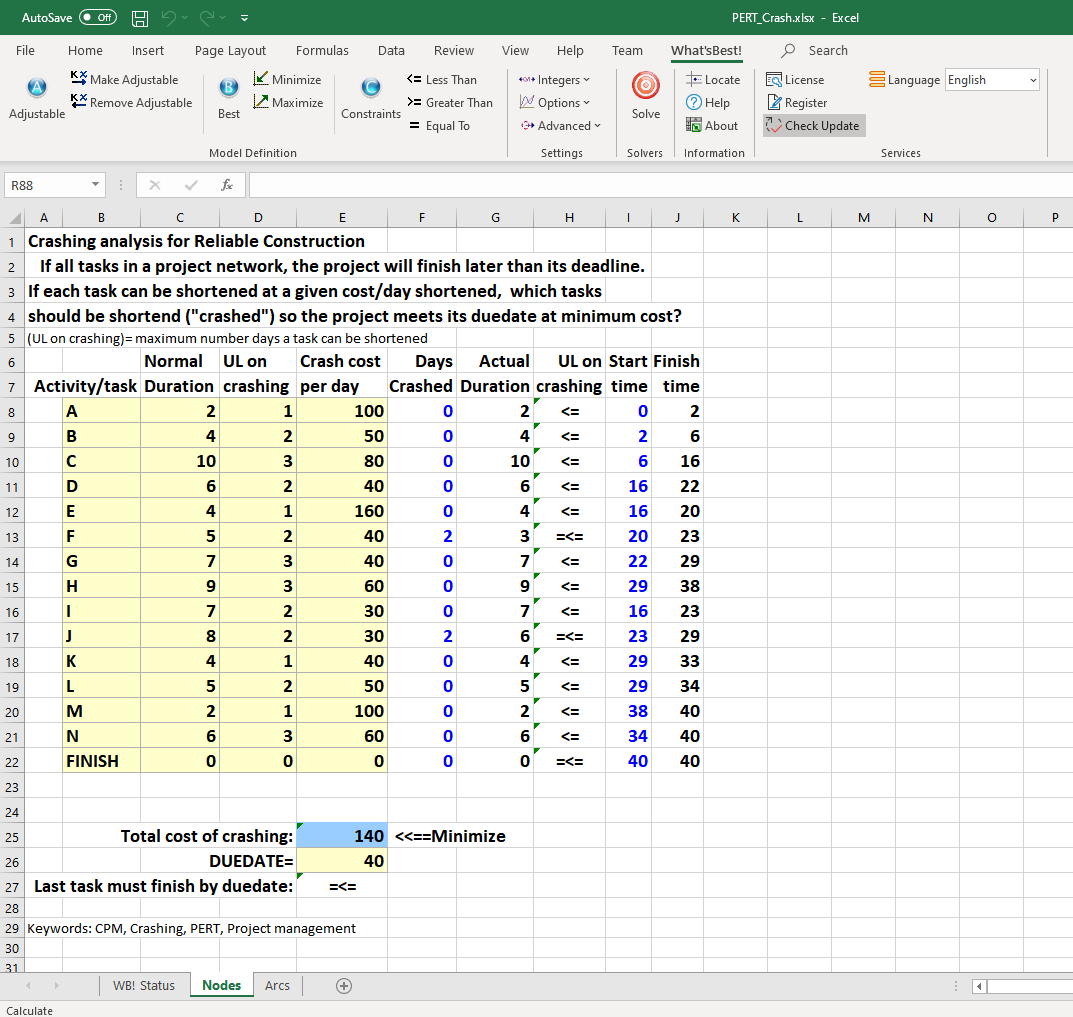

If all tasks in a project network, the project will finish later than its deadline.
If each task can be shortened at a given cost/day shortened, which tasks
should be shortend ("crashed") so the project meets its duedate at minimum cost?
